Site activity update – Tuesday 19 April to Monday 2 May 2022

Public holiday site closures

Our site will be closed on the Anzac Day public holiday (Monday, 25 April) and Labour Day public holiday (Monday, 2 May). Security will monitor the site during this time and all equipment will be safely and securely stored.

The project hotline, 1300 144 425 is operational between 9am and 5pm, Monday to Friday, including public holidays. If you are calling outside of these hours, please leave a detailed message and one of our team members will return your call on the next business day.

Caboolture Hospital Site Redevelopment map - 21 March 2022

Permanent power connection works for new Clinical Services Building

Due to the recent wet weather, works to connect permanent power supply for the new Clinical Services Building has been delayed. Our team are currently working on the first stage of the works which involves an under-bore near the south-eastern corner of the McKean Street roundabout across to the north-eastern side to connect existing conduits.

Temporary changes to the footpath on either side of McKean Street will be in place during these works to ensure pedestrians can safely move around the worksites. There will be no impact to traffic. Please see below map for details.

Once the under-bore section of the work is complete, the team will continue north towards the existing sub substation located on Jensen Road. Please refer to the attached notice.

What to expect:

  • An under-bore rig, vac-truck and equipment set-up outside the Multi-Storey Carpark site.
  • A receival worksite on the northern corner of McKean Street and on Mewett Street.
  • Slight change to footpath locations with signage and a traffic controller in place to safely direct pedestrians. Access will be maintained at all times.
  • Traffic signage in place on Mewett Street, McKean Street and Central Lakes Drive.

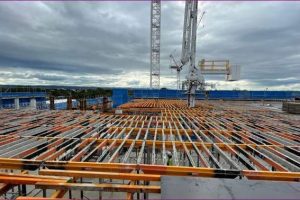

Clinical Services Building construction site – April 2022

Clinical Services Building construction site – April 2022

Clinical Services Building and Central Energy Building sites

Construction activities:

  • Installation of precast planks for the internal hospital access road.
  • Construction of suspended slabs on Level 5. Works include scaffold erection, formwork placement, reinforcement installation and concrete pouring.
  • Formwork, reinforcement and concrete pour activities for lift cores, stair cores and walls for the new Clinical Services Building.
  • Initial fitout and façade activities, including installation of high-level services for hydraulics, mechanical, fire protection and electrical.
  • Wall framing and sheeting on Levels 1 and 2.
  • Commencement of glazing and cladding on Level 1.
  • Formwork, reinforcement and concrete pour activities for the Central Energy Building.
  • Scaffold erection and commencement of blockwork for the Central Energy Building.
  • Installation of inground tanks.

What to expect:

  • Neighbours may experience some noise, dust and vibration impacts. Every effort will be made to minimise these impacts.

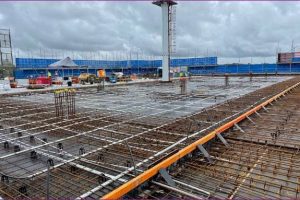

Multi-Storey Carpark construction site – April 2022

Multi-Storey Carpark construction site – April 2022

Multi-Storey Carpark site

Ongoing construction activities:

  • Installation of Level 4 and Level 5 suspended slabs.
  • Ongoing perimeter scaffold erection.
  • Formwork, reinforcement and concrete pour activities for lift cores and stair cores.

What to expect:

  • Neighbours may experience some noise, dust and vibration impacts. Every effort will be made to minimise these impacts.

Building and Engineering Maintenance Services (BEMS) Building site

Construction activities:

  • Excavation and installation of ground beams.
  • Civil infrastructure activities, including stormwater and drainage works.

What to expect:

  • Neighbours may experience some noise, dust and vibration impacts. Every effort will be made to minimise these impacts.

New storage facilities site (western side of hospital campus)

Construction activities:

  • Installation of suspended slab for the new oxygen storage tank. Works include formwork placement, reinforcement installation and concrete pouring.

What to expect:

  • Neighbours may experience some noise, dust and vibration impacts. Every effort will be made to minimise these impacts.

Thank you for your patience during the construction of the Caboolture Hospital Redevelopment.

The next Site Activity Update will be issued on Tuesday, 3 May.

COVID-19 update

The project team is adhering to the Queensland Government’s COVID-19 restrictions and essential works will continue onsite with all safety measures implemented. We continue to monitor and respond to all COVID-19 updates and requirements as per the Public Health Directions from the Chief Health Officer.


Find out more about the Caboolture Hospital Redevelopment Project. Lendlease Project Team Caboolture Hospital Redevelopment Project (CHRP) McKean St, Caboolture QLD 4510 1300 144 425 CabooltureHospital@lendlease.com  |  www.lendlease.com We acknowledge the Traditional Owners of country throughout Australia and recognise their continuing connection to land, waters and community. We pay our respect to them and their cultures and to Elders past and present. Lendlease Reconciliation Action Plan: lendlease.com/RAP
